When the budget meets the detail
Value engineering arrives on almost every project, usually right after the first cost estimate lands above budget. Done well, it trims waste and improves constructability. Done badly, it strips the quality out of a building one substitution at a time, leaving the architect to defend details that have quietly been hollowed out. The difference is largely a documentation problem.
Robust detailing anticipates the pressure. It states what an assembly must do — its thermal, structural, and waterproofing performance — separately from the specific product that happens to achieve it. That separation gives a reviewer something to measure substitutions against, instead of a yes-or-no fight over a brand name. The American Institute of Architects frames this as protecting design intent through the contract documents.
Details built to absorb substitution
A robust detail tolerates change at the edges without failing at the core. It dimensions the things that matter — the drainage plane, the air barrier continuity, the structural bearing — and leaves cosmetic choices flexible. When a cheaper cladding is proposed, the detail still tells everyone where the water has to go.

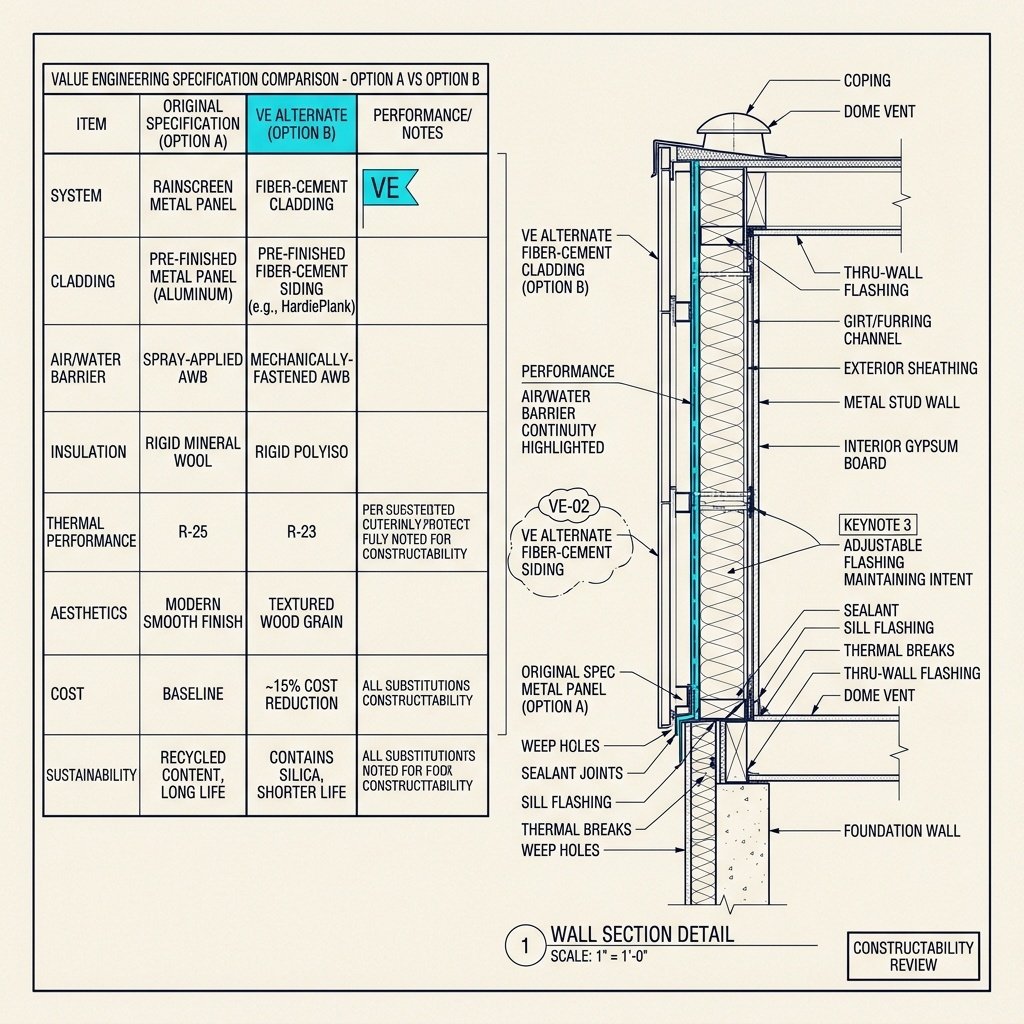

Value engineering does not have to mean value erosion — a well-detailed assembly tells you exactly what can be traded and what cannot.
That resilience starts in the model and the drawing conventions. It is the same rigor we describe in our technical callouts guide and deliver through our construction documentation services, where each critical assembly is detailed to make its performance legible.

Documenting substitutions and alternates
The cleanest way to control value engineering is to pre-empt it. Listing approved alternates in the specifications, with the performance criteria each must meet, turns a chaotic change process into a controlled one. A contractor proposing a swap then has a clear bar to clear — and the design team has a paper trail when something is rejected.
Whole-building performance references such as the Whole Building Design Guide help define those criteria. Keeping the spec and the drawings aligned matters here too — see our guide to keeping specifications and drawings in sync.
A process that holds the line
- State performance criteria in every critical detail, not just the product.
- Pre-approve alternates in the specs so substitutions have a defined bar.
- Require substitution requests in writing, measured against those criteria.
- Track accepted changes in the revision log so the record stays clean.
- Re-detail affected assemblies rather than annotating around the change.
When a swap is accepted, document it properly — our guide to revision clouds and issue management shows how to issue the change without confusion.
Frequently asked questions
What is value engineering in construction?
Value engineering is a structured review that seeks to reduce cost or improve constructability while preserving the function and quality of a design, often by proposing material or system substitutions before or during construction.
How can detailing protect design intent during VE?
Detailing protects intent by separating performance requirements from specific products, documenting why an assembly works, and providing pre-approved alternates — so a substitution must meet the stated performance rather than silently degrade it.
